Moving and linking stages
Re-plan the won project's dated stages on the timeline: stretch one, move another, then link them so the schedule reschedules itself.
What you'll achieve
The won stages run one after another, with their hours following the new dates, and are linked so a slip moves everything after it.
You'll end up with: Riverside Apartments' three stages, Concept Design, Documentation and Contract Administration, re-planned to run end to end from July to December, with their hours following the new dates, and linked so they reschedule together.
Before you start
Fix the programme where you can see it

This is step 1 of Plan the work. Riverside Apartments is won, and its three stages already have the dates and hours set on the Brief: Concept Design from July to August, Documentation from September to mid October, and Contract Administration from October to November. The timeline shows those dates as bars, so this is where you see the programme as a whole and fix it. Moving a bar changes the same task dates you set on the Brief, so both always show the actual plan.
A work programme has two levels. The project is one bar spanning the whole commission. Under it, once you expand the row, sit the stages, each its own bar. Allocations, invoicing milestones and reporting all hang off this structure.
- 1
Point at Schedules and choose Project schedule. The timeline opens ready to edit; changes wait for Save.
- 2
Switch the view to Monthly, and expand Riverside Apartments to see its stages.
- 3
Read the bars. Documentation ends in mid October, and Contract Administration starts on the first of October, so the two overlap. The client wants the drawings finished before building starts.
Stretch a stage
Documentation needs two more weeks. Click its bar to select it: the handles show only on a selected bar. Then drag its right end to the end of October. The start stays where it is.
Documentation books sixteen hours a week, so Monument asks what the longer dates mean for those hours, in Adjust resourcing hours?:
- Keep hours per period keeps sixteen hours a week. The total grows with the dates, from 112 hours to 144.
- Keep total hours spreads the same 112 hours over the longer dates, so each week gets fewer.
Fixed-total hours, like Concept Design's 240, stay as they are either way. Here the extra weeks are real work, so keep the hours per week.
- 1

Click Documentation's bar, then drag its right end to the end of October.
- 2
In Adjust resourcing hours, keep Keep hours per period and click Apply resize.
Tick Don't ask again to always use the choice you picked. It applies to you only. Change it later in Settings, Preferences, Resourcing on resize.
Move a stage

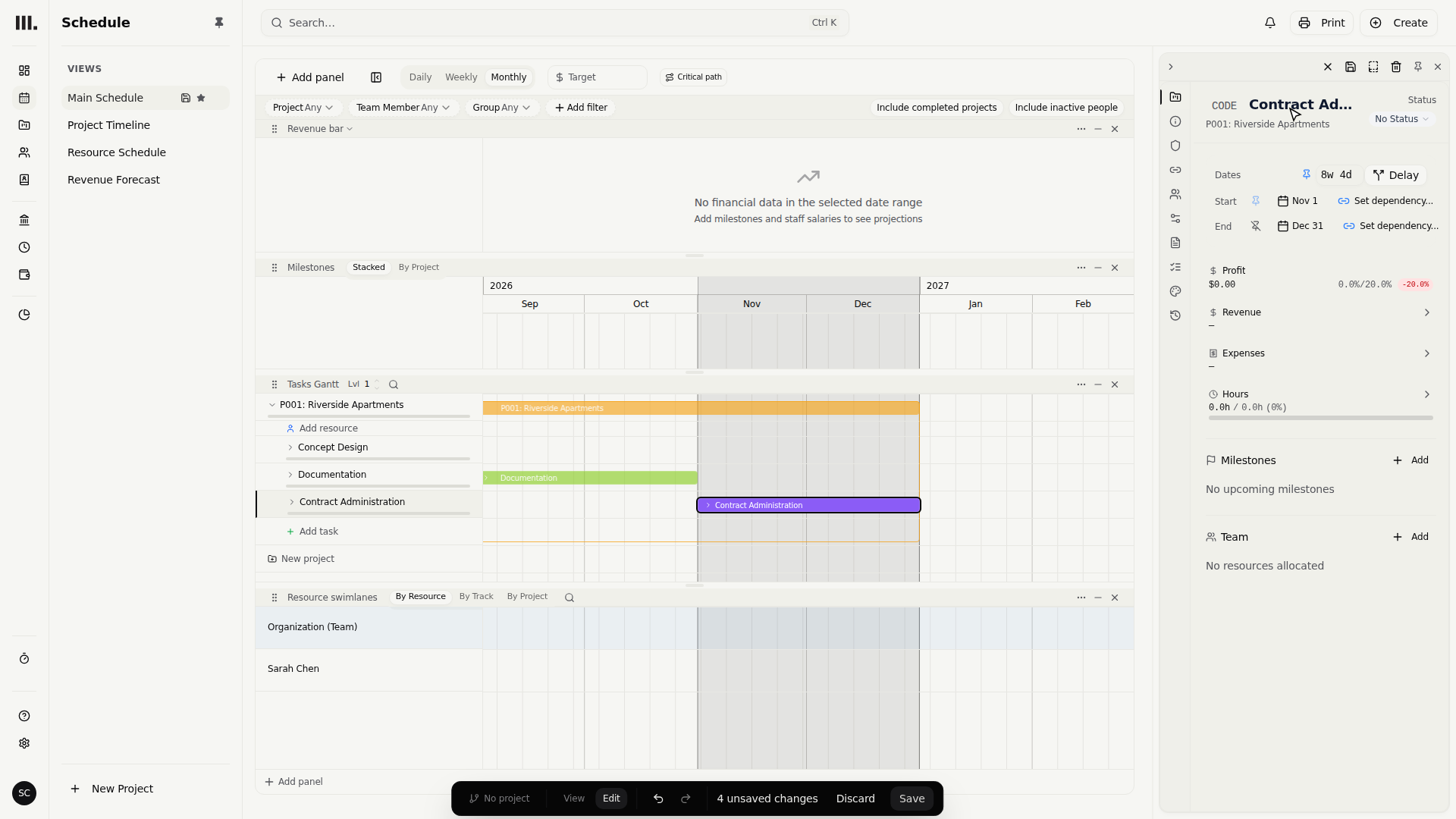

Contract Administration still overlaps the stretched Documentation. Drag the middle of its bar a month later. It starts on Monday 2 November, because a stage starts on a working day. A move keeps the stage's working days, so it now ends on 30 December, and its hours move with it.
- 1

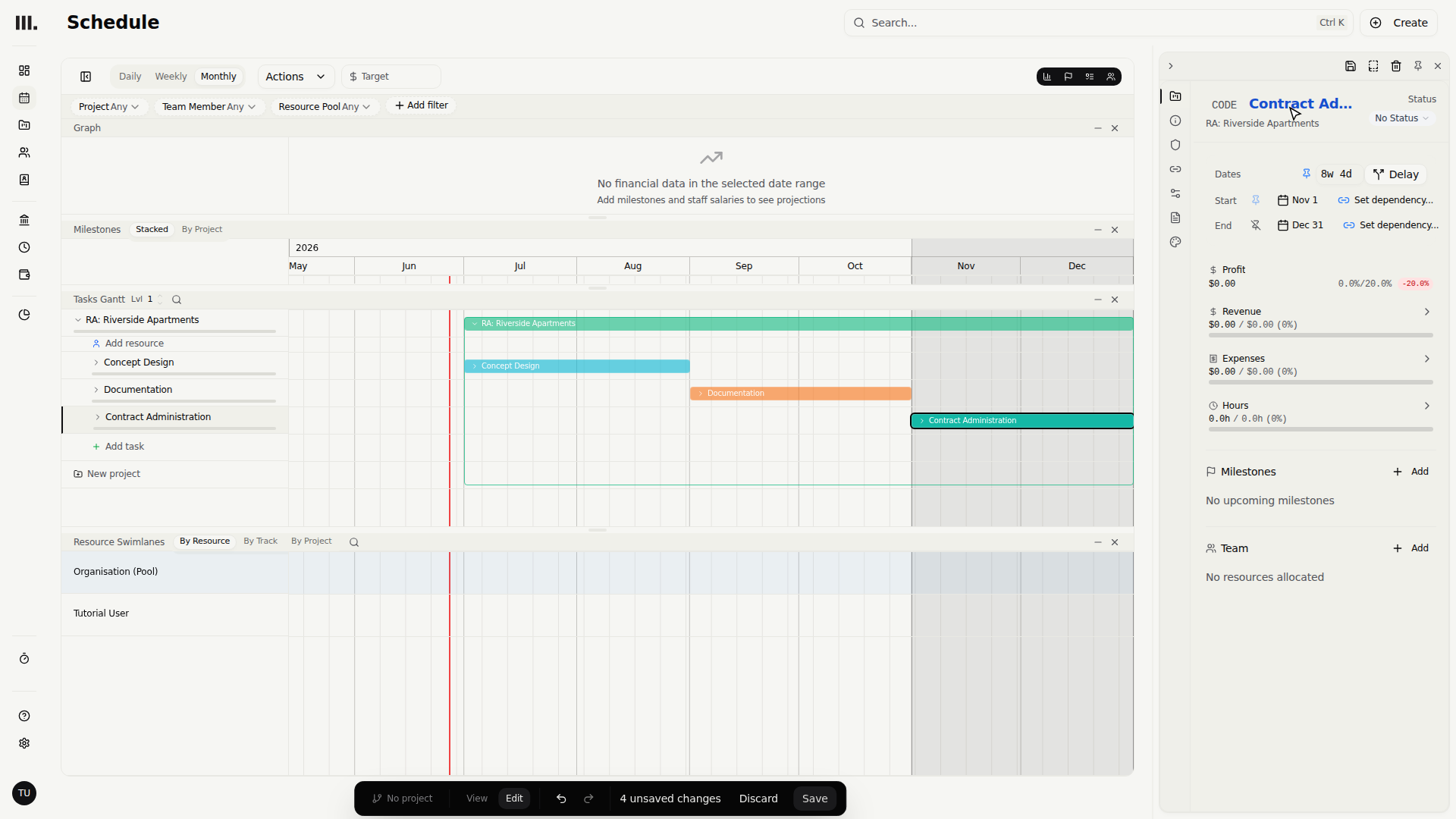

Click Contract Administration's bar, then drag its middle a month later, to start on Monday 2 November.
To add a stage that isn't on the Brief, drag in the empty lane under the project's stages. The New task dialog asks for its name and, for a fixed fee, its amount.
Link the stages so they move together
The three stages now sit end to end, but they aren't yet a work programme; they're just three tasks that happen to line up. What makes them a programme is the dependency: Concept Design has to finish before Documentation can start, and Documentation before Contract Administration. Draw that relationship by dragging from the end of one stage into the start of the next.
A link can join any two rows in the same project, not only neighbours: a task in one stage to a task in another, or stage to stage directly. Most links are finish-to-start, like the ones here, but a link can also be start-to-start, finish-to-finish, or start-to-finish, and it can carry a delay (in working days or weeks) or a lead, an overlap that lets the second row start before the first one is fully finished. Monument refuses a link that would close a loop, and names the loop it would make so you can see which rows to untangle.
Once stages are linked, they stop behaving as independent entries and start behaving as a chain: move the first one later and Monument pushes every stage downstream of it only as far as it has to, because the whole point of the dependency is that a delay in Concept Design is a delay in everything Concept Design feeds.
- 1
Drag a dependency handle from the end of Concept Design into Documentation.
- 2

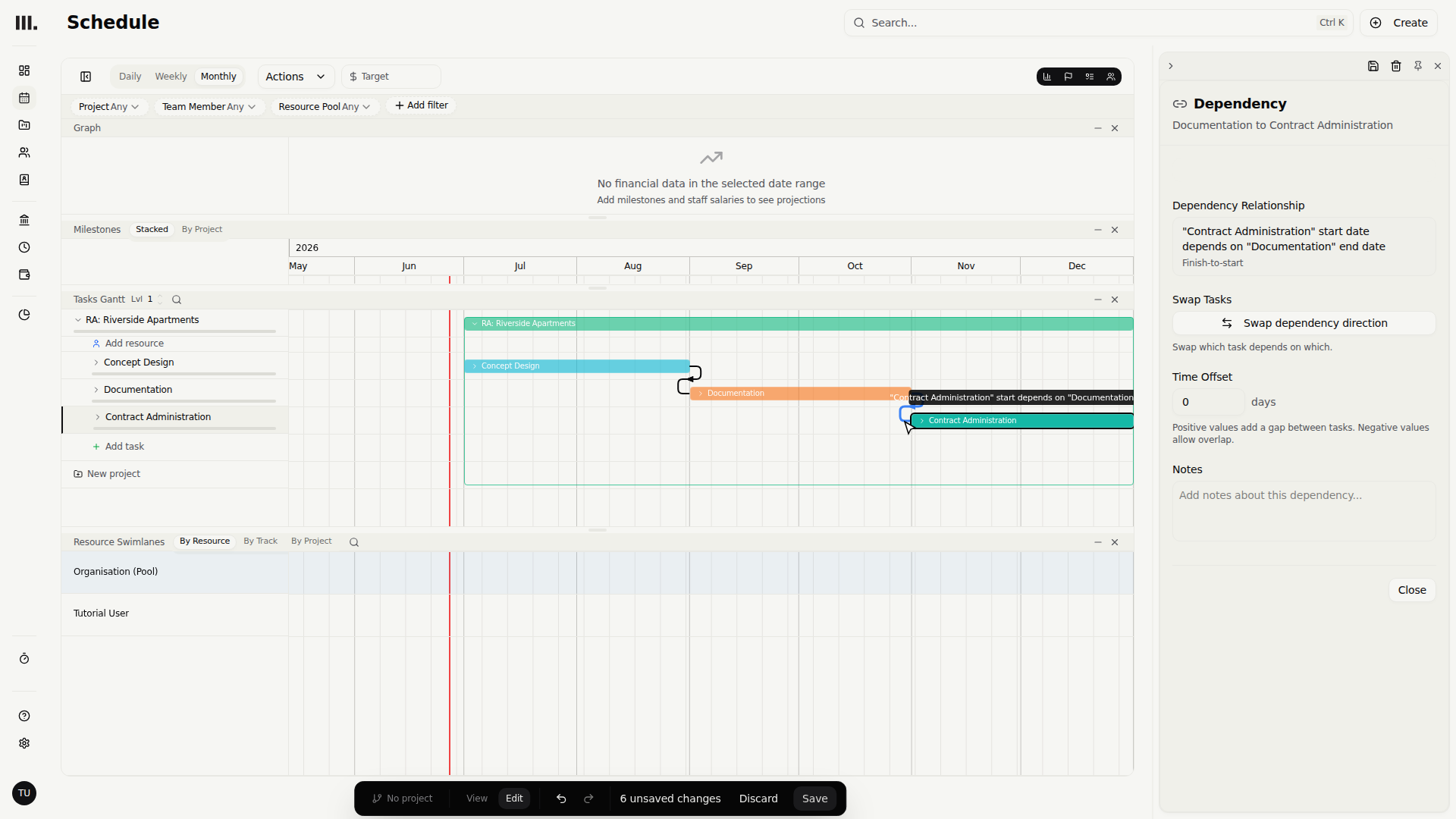

Drag a dependency handle from the end of Documentation into Contract Administration.
Click the link line itself to open a popover for that link: change its type or delay, or remove it. On a stage or project with several children, the Link in order button links them end to start in date order in one go, naming anything it skipped (already linked, would make a loop, or has no dates yet).
Type links in the Predecessors column
To see every link at once, open Columns in the Tasks panel's header, next to its title, and
turn on # and Predecessors. The left side of the schedule widens to make room, and the
column names show in the panel's header above them. # numbers the rows
in the order the list shows them. Predecessors lists the rows each task comes after, by
number: 2, 4SS+5d means "after row 2 finishes, and 5 working days after row 4 starts".
You can type into the Predecessors box. Use FS, SS, FF or SF for the link
type (finish-to-start is the default, so 4 alone means 4FS), and +5d or +1w for a delay,
-2d for a lead. Press Enter or click away to stage the change in the save bar. If Monument
can't make a link, for example a row number that doesn't exist or a link that would close a
loop, the box keeps what you typed and says why.
The same Columns menu adds more columns to the left side: how much room a task has (Float), its Latest start and Latest finish, its Deadline and Fixed date (both editable), its dates in the active baseline and how far it has moved, the tasks Before and After it, and whether it is Critical. See critical path and automatic dates for what these mean.
Link several tasks at once
Cmd-click task rows in the list (Ctrl-click on Windows) to select several at once, or click one and Shift-click another to select every task between them. The side panel shows how many tasks you've selected and what Link in order would add. Click it, or press Cmd+Shift+L (Ctrl+Shift+L), to link them end to start in date order. It skips the same things as the stage button and tells you what it skipped. Press Esc or click a single row to clear the selection.
See it work
The payoff of linking stages is that you don't have to manually push every downstream date every time something slips. Click Concept Design to select it, then drag it later and watch Documentation and Contract Administration push out to make room for it. A bar only moves once it's selected, so a stray drag across the timeline never shifts a stage by accident.
- 1

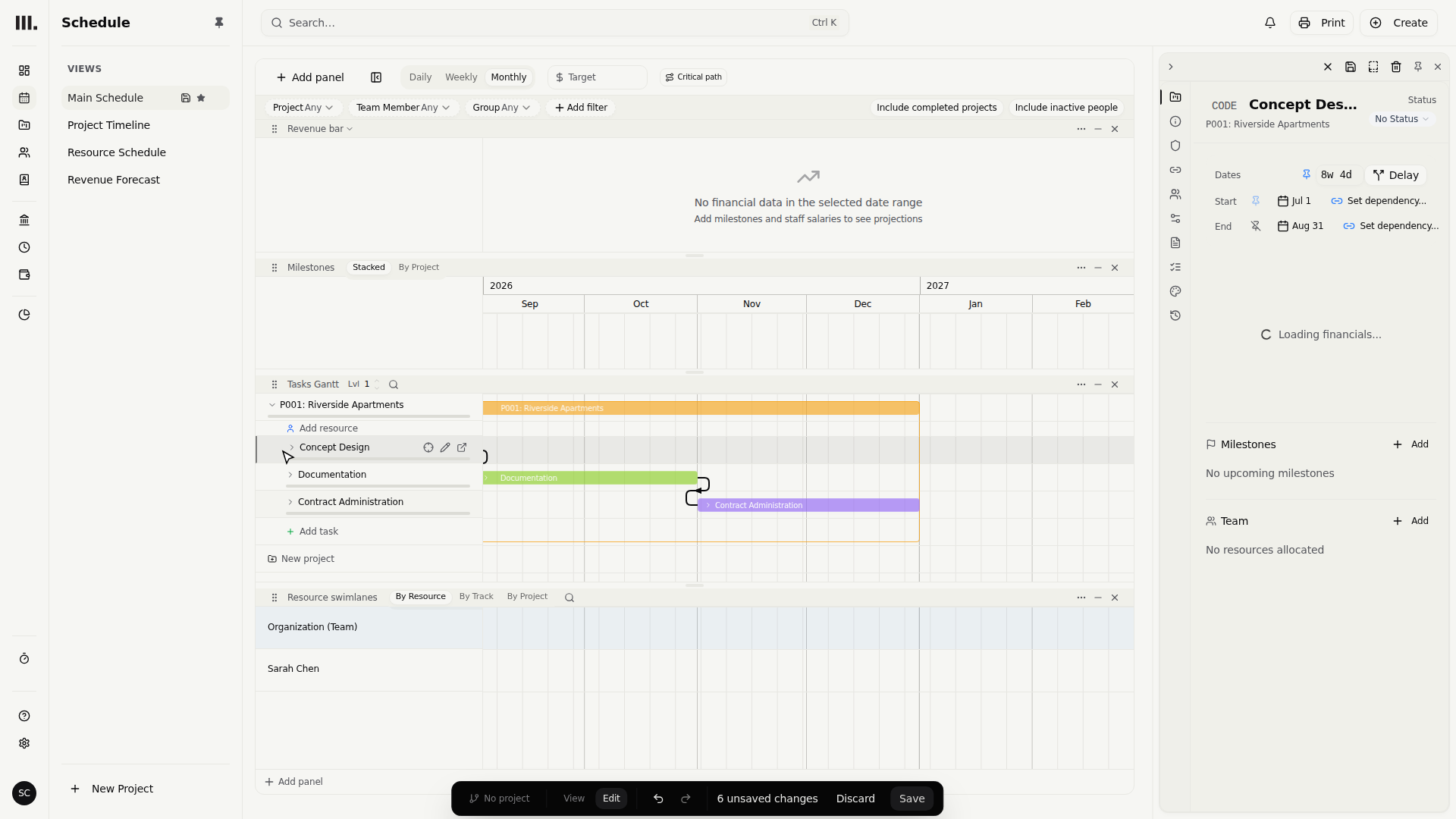

Drag Concept Design forward and confirm Documentation and Contract Administration move with it.

- 2
Drag it back towards where it started and confirm Documentation and Contract Administration stay where they are.
That second drag is the rule that matters most about links: they only push, they never pull. Moving Concept Design later pushes Documentation out because the link demands it, but moving Concept Design back earlier doesn't pull Documentation back with it โ Documentation stays put, and the gap that opens up in front of it is room to move, not a problem. See critical path and automatic dates for how Monument shows that room, and what else a drag will and won't do.
This is also the moment to notice what dependencies don't do: they reschedule dates, not scope or resourcing. If Concept Design slips two months, the practice still has to decide whether Documentation absorbs the delay or the whole commission's deadline moves; Monument only guarantees the stages stay in the right relative order once you've told it they're linked.
Save
Click Save once the programme looks right. Save updates the project's working version in place. To keep a rollback point, open the version selector and save the working version as a baseline.
- 1
Click Save. The new dates, the hours that follow them and both links save together. The three stages sit end to end with arrows between them.
Troubleshooting
If dragging does nothing, click the bar first: a bar moves only once it's selected. If it still won't move, check your permission to edit the project and whether the record is locked. Permitted schedules open ready to edit; there is no Edit switch to turn on.
A bar in the wrong place doesn't need to be deleted and redrawn. Click it, then drag its middle to shift it in time, or drag either edge to make it longer or shorter. Treat every bar as adjustable, not disposable.
Drew a dependency by accident? Click the link line and choose Remove link from the popover. The two stages keep their current dates and simply stop moving together, so undoing a link never undoes the dates you've already set.
Wide drags get fiddly at a tight zoom. Riverside Apartments' six months fit comfortably at Monthly, the zoom this article uses throughout; drop to Daily on a project this size and the programme runs off the edge of the screen, turning one confident drag into several careful ones.
