Grouping fees

Put a stage's hourly fee and its fixed fee in one fee group with an agreed amount. You keep every fee for planning. The client sees one price and one printed line.

What you'll achieve

Price a stage at one agreed amount while you keep its hourly fee and its fixed fee as separate fees.

You'll end up with: A stage that earns one agreed price, with its hourly fee still inside the group as a margin check, and one line on the client's invoice.

Price the work: if your contract has one agreed price for several pieces of work, group the fees. You'll know it worked when the group's Total equals the contract.

A client often agrees one price for a stage. Inside Monument, that price can come from more than one fee: the hours you plan, a fixed amount for a deliverable, a sub-consultant you pass on. A fee group keeps those fees as real fees for you, and shows them to the client as one fee.

This example prices the Concept Design stage of Riverside Apartments at one agreed amount of $120,000.

How a fee group works

A fee group is a fee that holds other fees. Its total is the sum of its items.

  • Every item stays a real fee. The hourly fee still follows the hours. The fixed fee still holds its amount. You still see each one in the schedule, the reports and the invoice editor.
  • Totals count the group once. The stage total, the project total and every report count the group, never its items as well.
  • An agreed amount fixes the total. Set an agreed amount and the group always totals that amount. A balance item, named Labour, takes the difference. When the hours grow, the hourly fee goes up and the balance goes down by the same amount.
  • The client sees one line. The printed quote, the printed invoice and the accounting export show one line per group. The items never print.

The stage's default hourly fee, Revenue from Allocations, can go in a group. It stays in that group when the hours change, when you copy the project, and when you make a new version.

Group the fees and set the price

The Concept Design stage already has two fees: the Fixed Fee from when the stage was made, and the Revenue from Allocations fee that follows the hours.

  1. 1

    Open the Concept Design stage, and open its Revenue list.

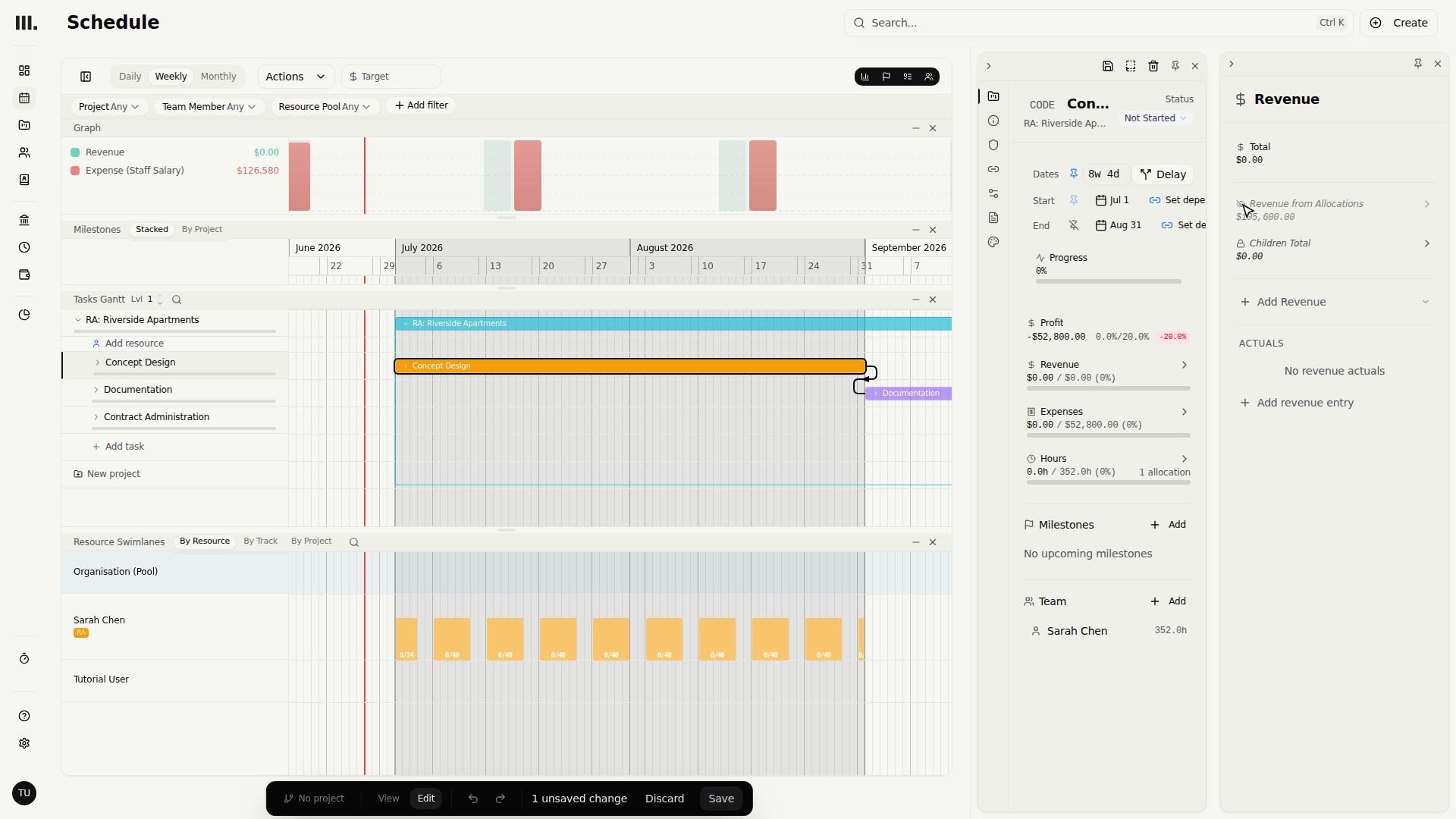

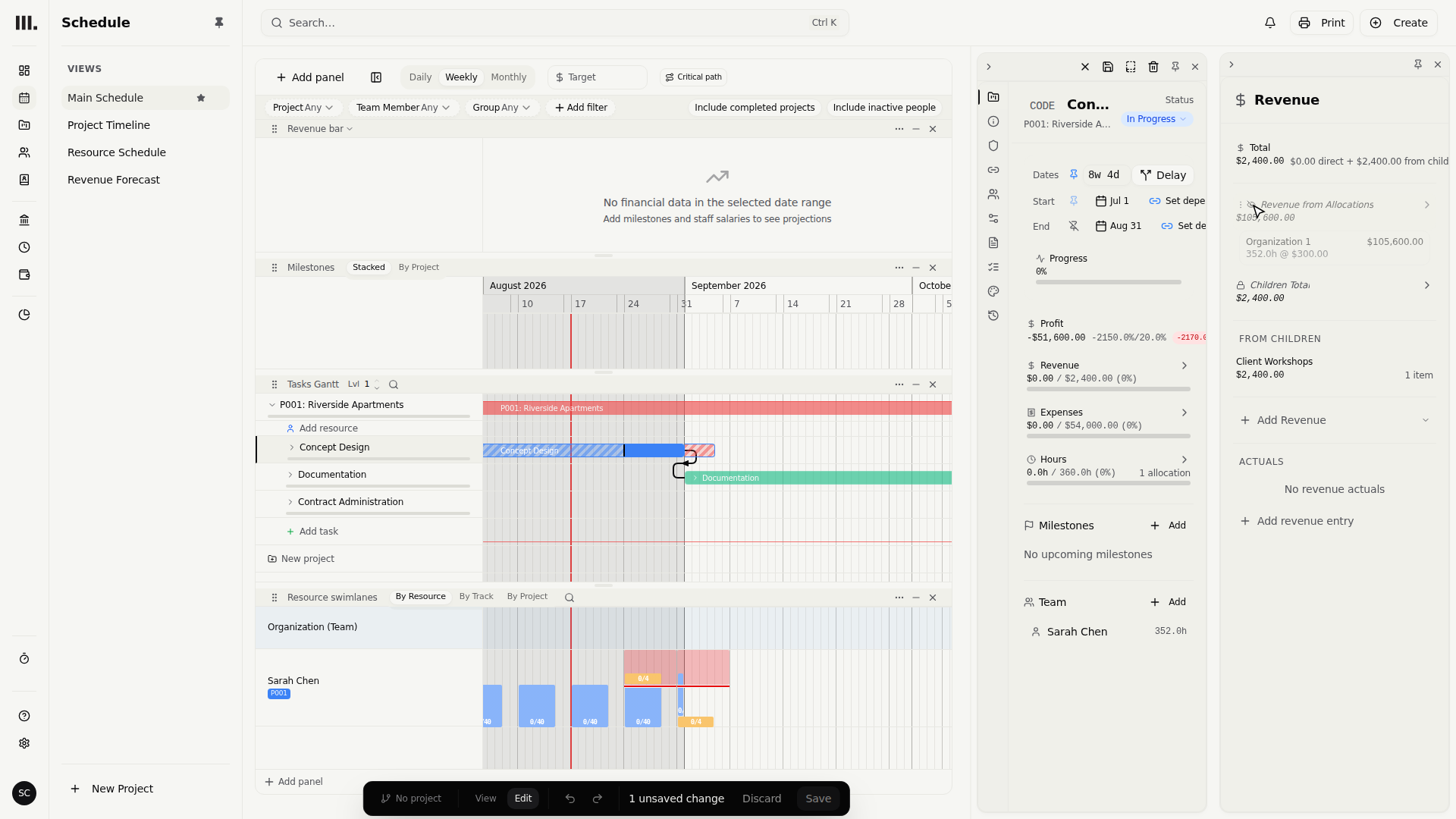

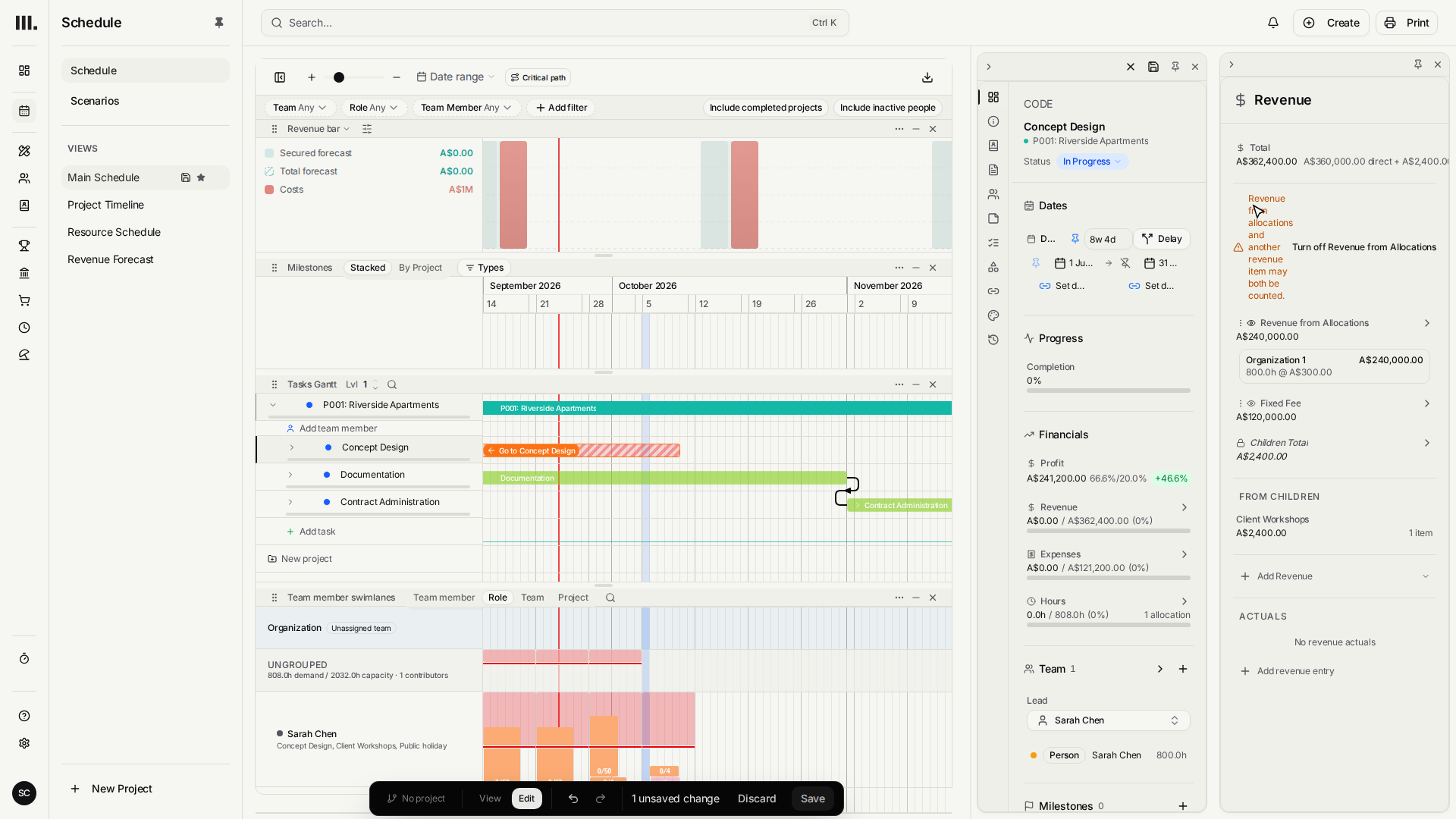

  2. 2

    Tick the Revenue from Allocations fee and the Fixed Fee.

  3. 3

    Choose Group selected. The two fees move into a new fee group, and the group opens beside the list.

  4. 4

    Name the group Concept Design fee. This is the name the client sees.

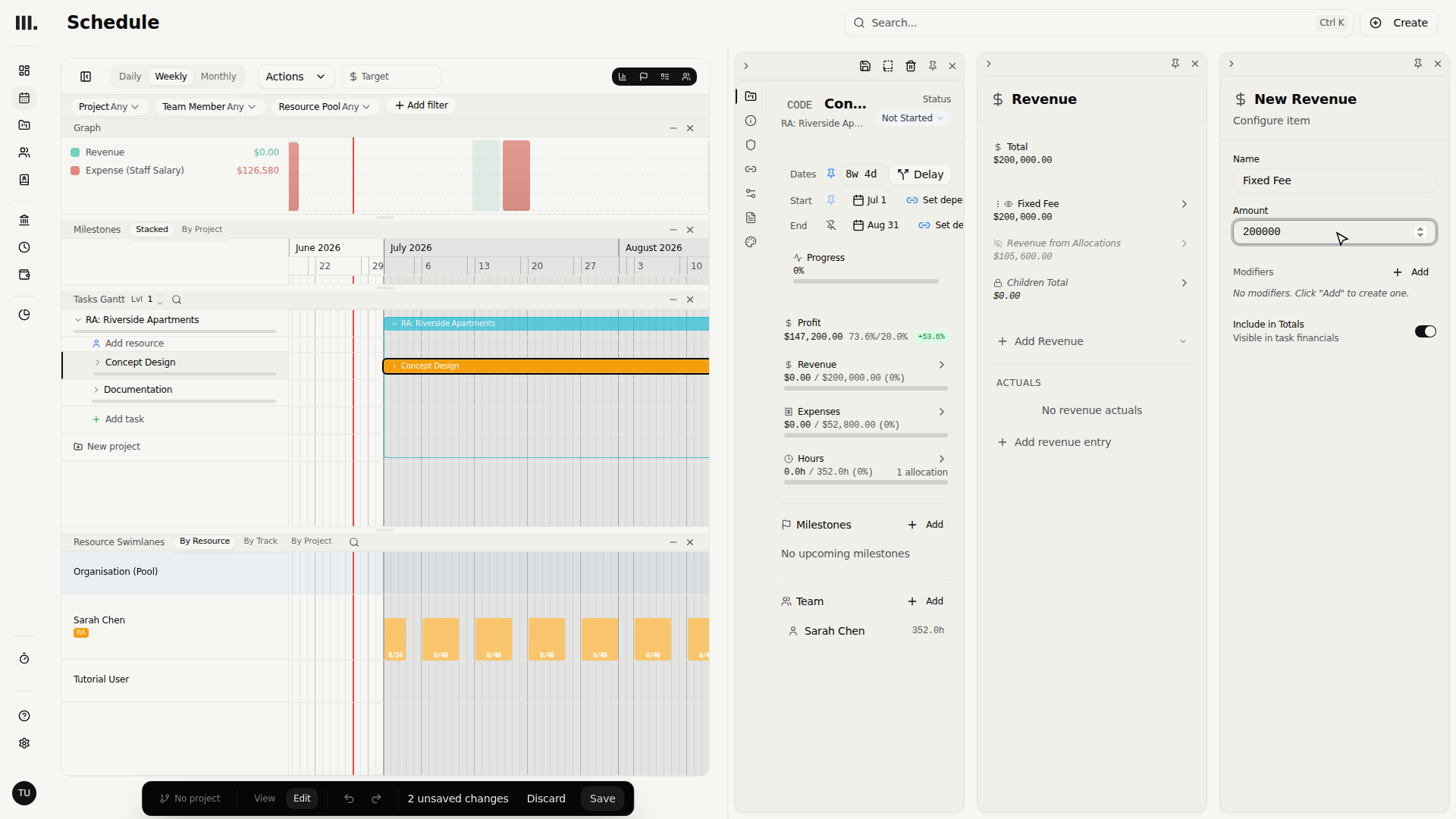

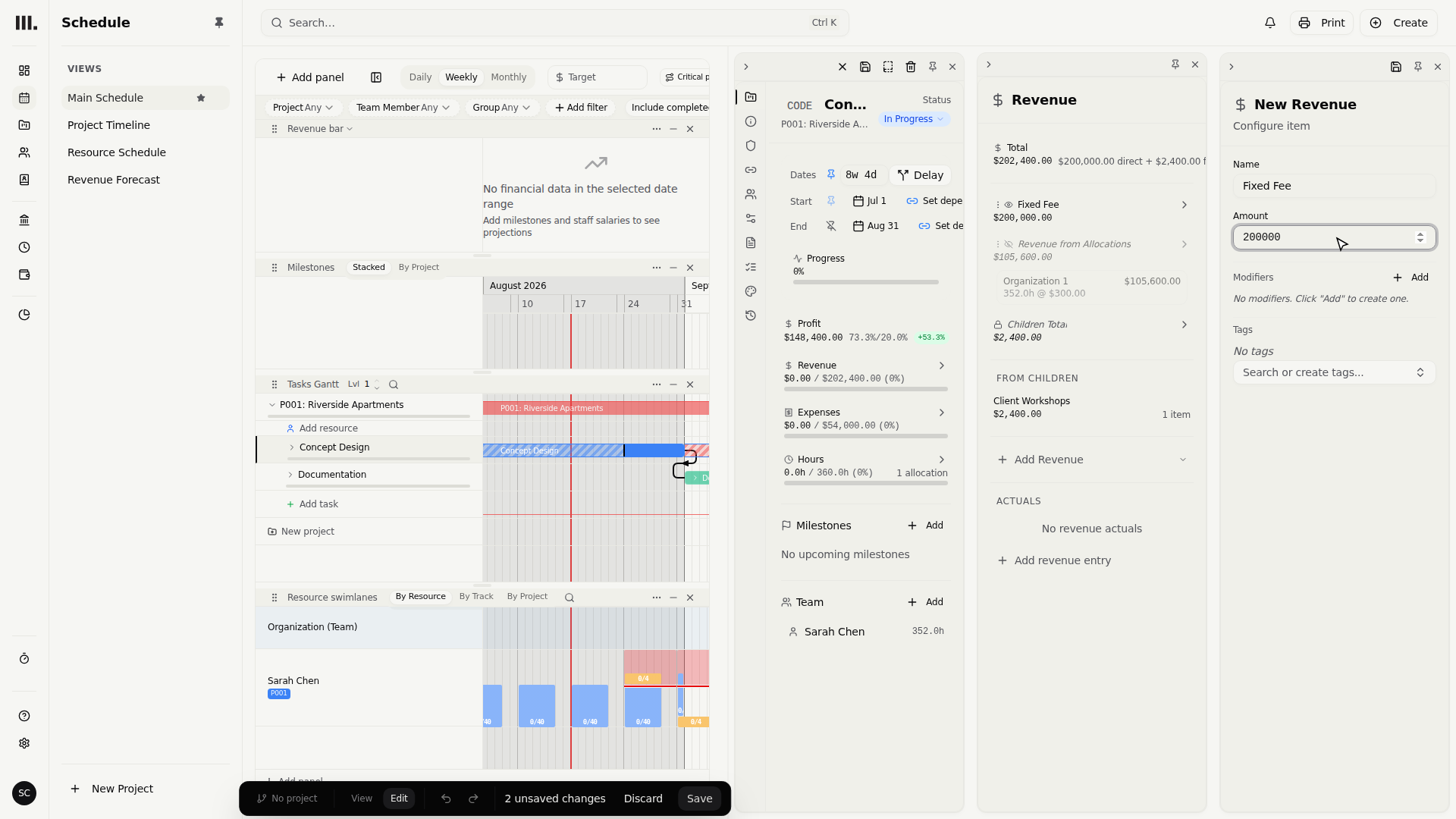

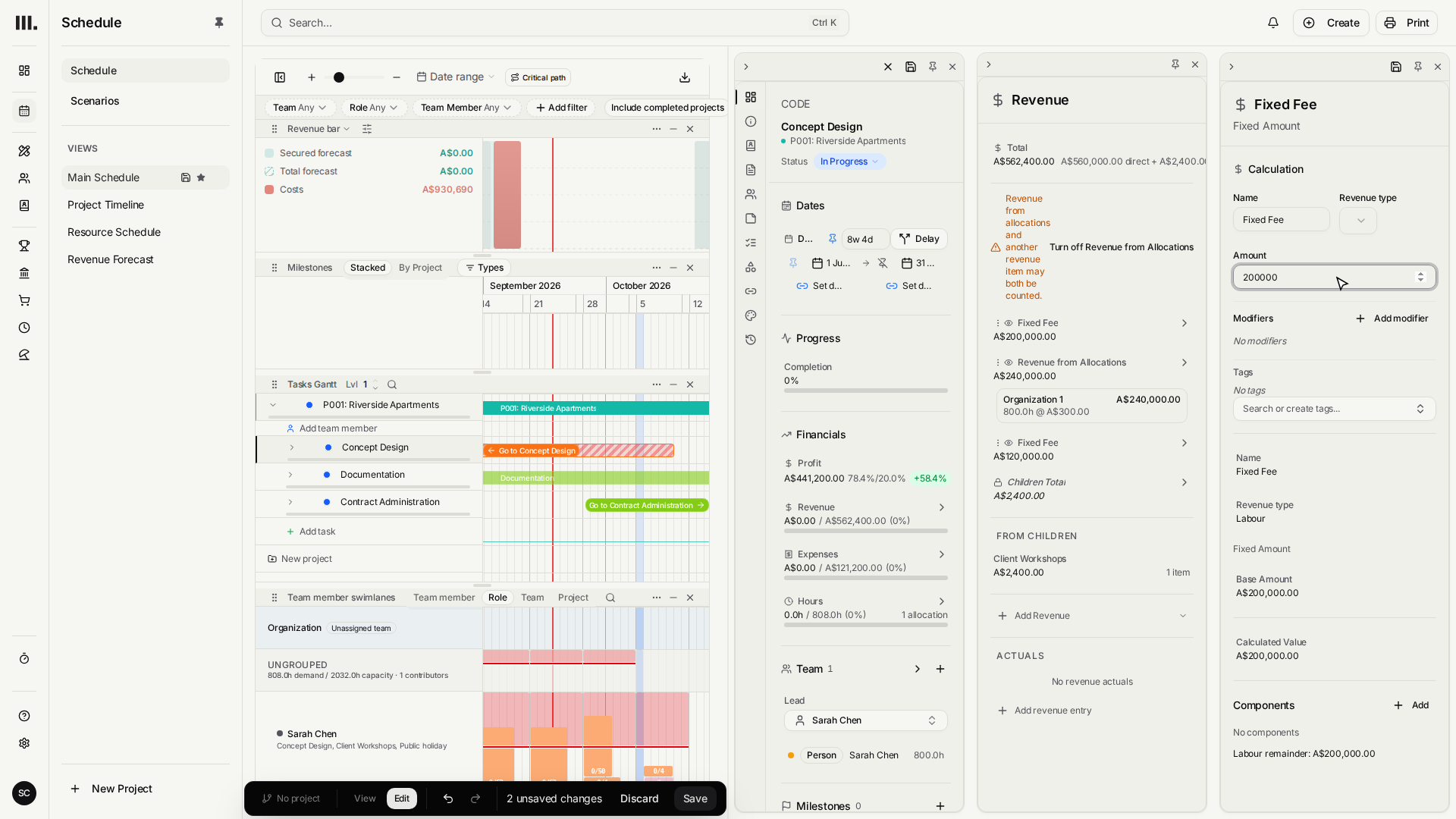

  5. 5

    Set the agreed amount to 120,000. The group total is now $120,000, and a Labour balance takes the difference.

  6. 6

    Read the Printed line. It shows one line: Concept Design fee · 1 × $120,000.00.

  7. 7

    Click Save to keep the changes.

Choose how the line prints

The group panel's Show on invoices as setting decides how the one printed line reads:

  • Fixed amount prints 1 × $120,000.00. Use it when the client pays the price in one claim, or when you don't want to show progress.
  • % progress prints the percentage claimed against the group total, for example 25% × $120,000.00. Use it when you claim the price stage by stage.

The setting changes only how the line reads. The amount always comes from the items inside the group. See fee groups on invoices for the invoice side.

Troubleshooting

  • The items are more than the agreed amount. The group shows "Items are $X over the agreed amount" in red, and the balance goes below zero. Save still works. Raise the agreed amount, or lower an item.
  • Group selected is greyed out. All fees in a group bill at one tax code. Fees with different tax codes can't share a fee group. Change the fee's tax code, or keep it outside the group.
  • The total didn't change when I added the agreed amount. That is correct when the items already add up to the agreed amount. The balance is then $0.00.
  • I want the fees back as separate fees. Open the group row's menu and choose Ungroup. The items stay at the group's place in the list, and the balance becomes an ordinary fixed fee at its current amount.

Where this fits next

Next, if your contract says a percentage of construction cost, use formula-based pricing.
